INSTALLATION of the latest phase of work to protect Dawlish and its iconic coastal rail line is now complete.

Network Rail has announced the programme of construction of the new and bigger sea wall has reached another major milestone.

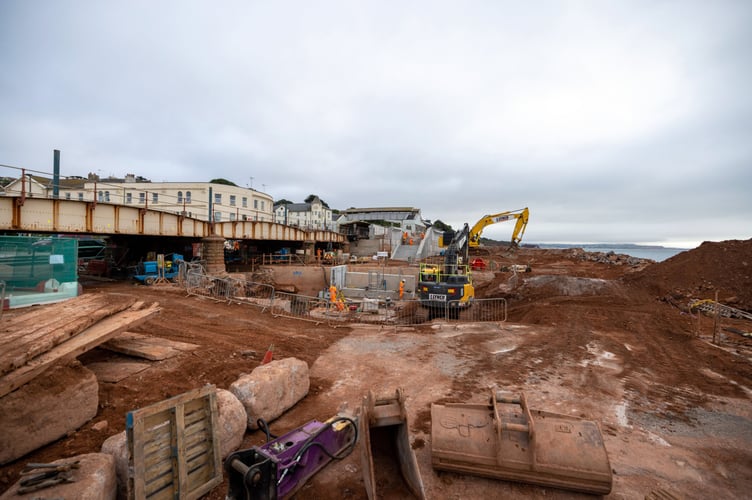

The installation of all 164 wall panels, 203 pre-cast blocks and 189 recurve units which return waves back out to sea is now complete.

The innovative design, along with the increased height of the new sea wall will, is expected to prevent delays and disruption to passengers by minimising the likelihood of the tracks flooding and allowing the line to reopen more quickly after major storms.

The first section of new sea wall – which runs for 360 metres along Marine Parade south west of Dawlish station – was completed in July 2020.

Construction of the 415 metre second section from Coastguard breakwater, north east of Dawlish station, to Colonnade breakwater began in November 2020.

A spokesman for Network Rail said: ‘Following the significant progress made installing the wall panels, blocks and recurve units, Network Rail and its contractors BAM Nuttall are now fully focused on completing the link bridge that will connect the two sections of public, accessible promenade and the new stilling basin, where Dawlish Water runs into the sea.

‘This work is now expected to be finished in December, due to the discovery of an uncharted gas main in June which delayed piling to install foundations for the new link bridge close to Colonnade viaduct.

‘While construction is ongoing, for the safety of the public the access to the King’s Walk promenade and beach at Colonnade underpass will continue to be intermittently open.

‘Every effort will be made to open it when it is safe to do so and times will be communicated in advance.’

The final part of the project will see the construction of a new, accessible footbridge with lifts at Dawlish station, meaning any passengers, residents or visitors will have easy step-free access at the station for the first time.

Work is due to start in September, with the bridge due to open next summer.

Ewen Morrison, Network Rail senior programme manager, said: ‘Achieving resilience for the railway in Dawlish is a major milestone not just for Network Rail, but for our passengers, the town and the south west region as a whole.

‘It’s what we set out to do when we were awarded £80m of funding from the Department of Transport back in 2019.

‘This landmark moment is testament to the hard work and coordination of staff from Network Rail and our contractors BAM Nuttall who have worked under extremely challenging conditions around the tides and through the seasons as well as during the Covid pandemic. We would like to thank everyone for their continued patience and understanding while we complete the work as quickly and safely as possible.

‘As we near completion of the sea wall, it’s exciting to know the positive impact this project will have in Dawlish, which will provide greater protection to the railway from rising sea levels and extreme weather for generations to come.’

The new sea wall at Dawlish is part of Network Rail’s ongoing efforts since the storms of 2014, which wrecked the rail line, to improve the resilience of the railway between Dawlish and Teignmouth in Devon, known as the South West Rail Resilience Programme.
